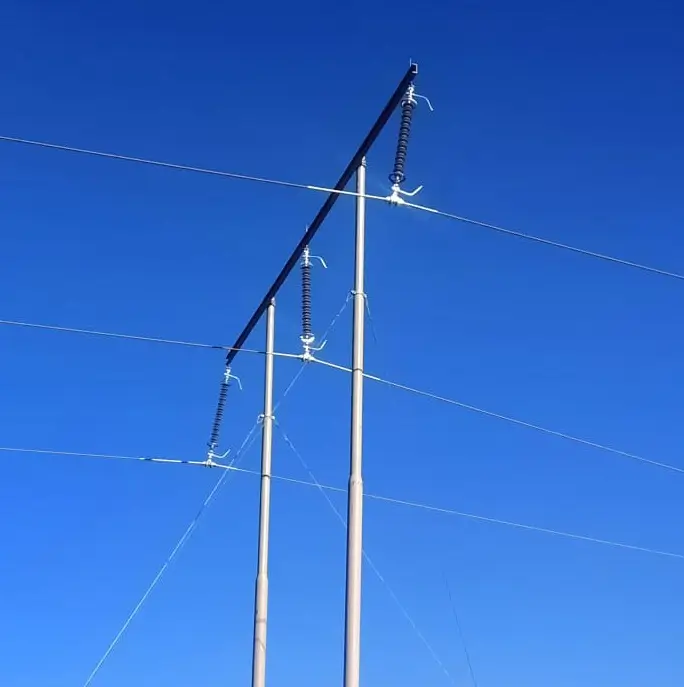

KE has planned to erect a new double circuit of 132kV transmission line from Hub-Chowki to Bela grid and enhancement of grids in Vinder, Uthal & Bela from 66 kV to 132 kV in line with the Company’s vision to bring a substantial change in the rural parts of its service territory by upgrading its infrastructure, to meet the increasing load profile and to support economic expansion. In addition to the above, continuing with execution of large-scale rehabilitation project on Hub to Uthal transmission lines at an expedited pace, the execution of scope for Phase-I has reached 98% whereas Phase-II was initiated and achieved progress of 93% in FY 22 alone, and both phases are expected to be concluded by December 2022. The project has already yielded a decrease in number of remote line trips by 51% and unserved energy against remote line trips by 55% as against previous year.
